BUILDING A CONTAINER HOME IN THE COLORADO MOUNTAINS

Result: Ongoing. Ask me a year ago and I would have said mixed. The house worked: built, permitted, and the cozy desert Southwest home I always wanted. The money did not, at least not yet. Construction came to about 617,000 USD all-in on a 12,500 USD lot, more than half of it site work and water, and with a property management company running it, the cash flow came in below what I built it for. The first year added its own surprise: rotten-egg well water that has taken about 9,100 USD of fixes so far. So in fall 2026 I am trying something new: managing the rental myself, with AI and LLMs doing most of the work. My hypothesis is that this gets the cash flow close to where I want it.

The Problem

In 2021, I REALLY wanted a house that was exactly my own. No, not some mass-produced Lennar house in a subdivision A depressing Front Range view: https://maps.app.goo.gl/BR7qeqY3J43ESAji6 , but a location I enjoyed, sited in a daring way, with the industrial minimalism that matches my values.

I also wanted more cash flow. In 2020 and 2021, rates on stored cash were effectively zero https://fred.stlouisfed.org/series/FEDFUNDS and, as usual, asset prices went the other way: higher than I believed their valuations should be. Stuck inside during COVID-19, I went off the diving board into the deep end of oligarch finance and accredited investing. My world view changed from “the future will be better” to actively living my better future.

In startup-land we talk about ARR https://corporatefinanceinstitute.com/resources/valuation/annual-recurring-revenue-arr/ a lot: how much cash you will have coming in each year. Applying the same idea to my life, JZ the business needed to hit a yearly number that made it profitable without a standard paycheck.

Hypothesis: Cheap land in a county that lets you build your own way, plus a factory-built home, gets me a getaway that also pays for itself as a short-term rental.

The Solution I Tried

Pick a county that lets you build

What I wanted:

  • Year-round activities: mountain biking, snowboarding, splitboarding, rafting, motorbiking
  • Good food and some cultural events
  • Affordable
  • Driveable from my (at the time) main work location in the foothills around Boulder and Golden

The shortlist: Grand Junction, Gunnison, Hayden, Norwood, Pagosa Springs, Pinedale, Poncha Springs, Sheridan, South Fork, Taos. I narrowed it to Pagosa Springs and Taos because of their libertarian approach to housing: I could build what I wanted, how and when I wanted, with less paperwork than most places. Creede in Mineral County was another interesting spot. Some Colorado counties, Mineral, Baca, Sedgwick, Delta, and Montezuma among them, have no building department at all. The state’s new wildfire resiliency code (SB23-166) reaches wildland-urban interface areas even there. CCI summary

I picked unincorporated Archuleta County (Aspen Springs 3), just west of Pagosa Springs:

  • Close to tourist attractions, which drives occupancy
  • Good food
  • Many mountain biking options
  • Mild climate with quick access to big, snowy mountains
  • Driveable for a long weekend

The catch: high fire risk and very few property insurance options. Take a look at https://co-pub.coloradoforestatlas.org/! I could only find commercial coverage through https://www.coloradofairplan.com/ with a 1,600 USD/year premium.

Buy the lot sight-unseen

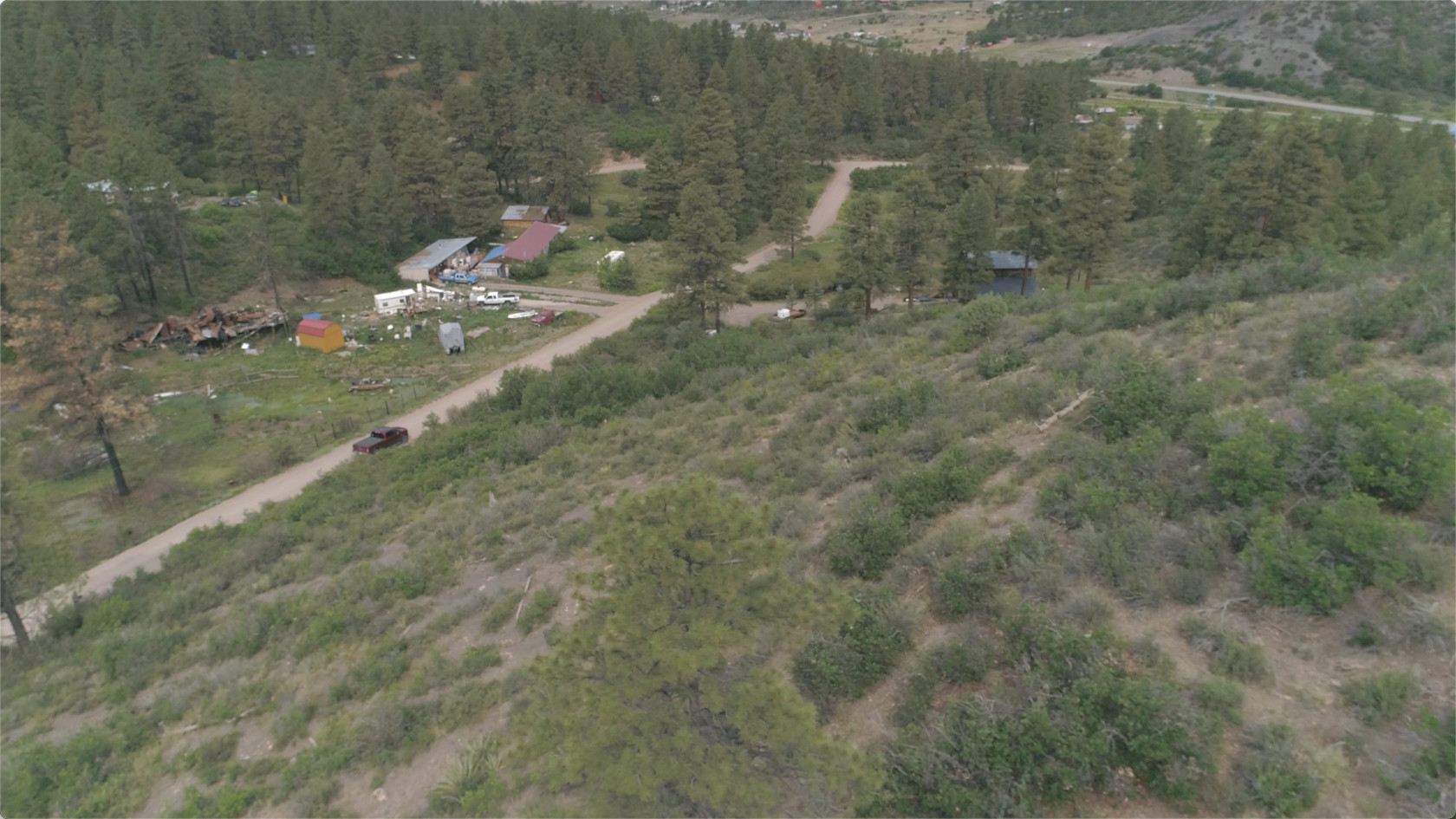

On April 22nd 2021 I closed on an acre on the side of a hill for 12,500 USD, through one of my Colorado business entities. Great view, lots of privacy, and almost no rules about what I could do with it.

I knew the area, had looked at satellite imagery, and studied topo maps, but I bought it sight-unseen. So I hired a drone operator for an aerial survey to figure out where to put the structures. Everything from the red pickup truck to the flat bit on the right side of the image was in play: Aerial view of the hillside lot in July 2022

Buy a factory-built house

Over the summer and fall of 2021 I went through the list of manufactured home producers registered to sell in Colorado. Most sellers near my land never answered. Custom Container Living did, with a reasonable delivery timeline, upfront ballpark pricing, and online designs to pick from. For my budget, space needs, and delivery constraints I went with the Double Duo.

Permits and excavation

Reading Archuleta County’s Modular building permit in 2022 wasn’t too painful, even before consumer-grade LLMs took off. What the packet asked for:

  1. Complete Building Permit Application: easy, just contact details
  2. 11X17 Proposed Site Plan by a Colorado Licensed Surveyor: a few months and a few grand with an engineering firm
  3. (2) Sets of Plans: the rural county wanted paper https://theplanprinter.com/
  4. Access Approval & Right of Way Permits: pay the fee, bore under the road for electrical, build a driveway over a metal culvert, pass the final inspection
  5. Sanitation: design the septic system with an engineering firm like Davis Engineering, build it with an excavation team like Pagosa Landworks, then get the final review once it is powered with a warning alarm
  6. Pagosa Fire Protection District impact fee
  7. Proof of Ownership: already had this from closing
  8. HOA or POA approval: N/A for Aspen Springs, they only maintain the dirt roads
  9. Pay the permit fee (cash or check only)

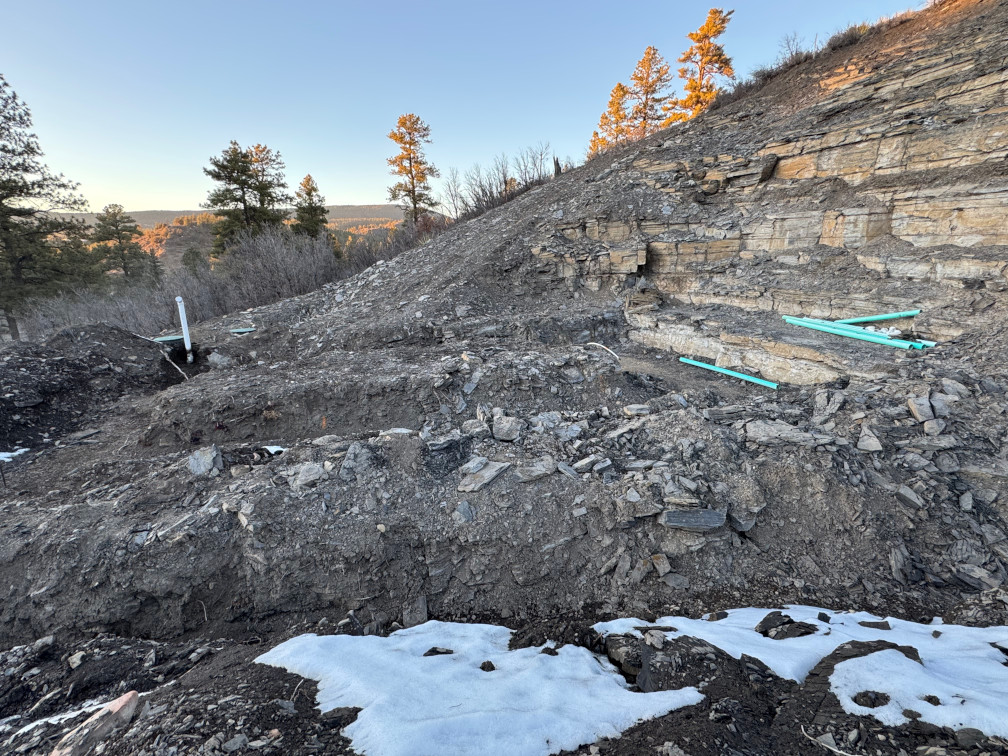

Pagosa Landworks took massive amounts of material out of the hillside, and we did some extremely creative things with Davis Engineering. You could probably cut the excavation cost in half on a flat lot.

Water

By this point I had become much more averse to novel construction. I had planned a rain water collection system with a massive underground cistern. After some confident words from DAK Drilling and Well Services, I went with what most people in the area do: drill a well.

The San Juan River basin is already overtapped, and it is part of the Upper Colorado River Basin, where USGS projects groundwater flow to streams could drop 29% by the 2050s in a hot, dry scenario. My guess is 5-10 good years out of the well, then another 5-10 mediocre years with the very large pressure tank I put in. That gives me lead time to add a proper cistern later. The only legal use for this well water is inside domestic use (showering, drinking, washing), then back into the ground through the septic system.

Just drilling the well to ~500ft was 52,050 USD. They make you sign a contract saying they may never hit water. A flat lot closer to surface water would probably take 25-50% off the drilling price. All in, the well, pump, pressure tank, treatment system, and well house came to 125,476 USD. Still way better than having water delivered like some of the neighbors.

Electricity

Electricity was far simpler than water. The power pole was across the dirt road, and we put the house as close to the road as possible. That kept down the cost of the driveway, the slope of the driveway (code has a maximum), and the cost of running power to the lot disconnect.

Alpine Excavation bored horizontally under Echo Ln to the power pole on the other side and fed conduit through the hole. Much cheaper and simpler than cutting into the road. JBX Electric put in the main power pedestal disconnect Think something like: https://www.youtube.com/watch?v=0yc7c_axEy8 , fixed some internal wiring once the house was delivered, and wired the septic and wellhouse.

Foundation: hire the pro

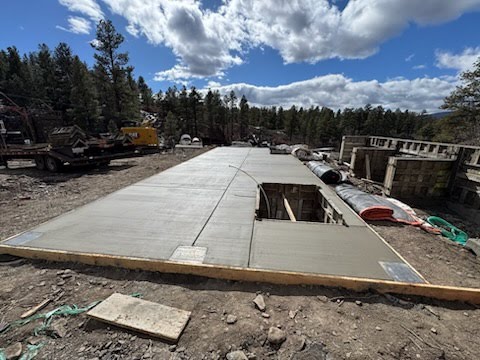

This is the most critical part of any build, and the part I handed to HYS Construction. There is no way to do it well remotely with no general contracting experience. The plans from Custom Container Living were missing some crucial details, and most construction workers have never seen the modular style we were attempting.

Hiver was absolutely amazing to work with! The traveling crew took a coarsely excavated lot in February 2025: Excavated building pad in February 2025

To a finished foundation with welding embed plates from my friend Andrew’s shop, Somnus Customs LLC, in March 2025: Finished foundation in March 2025

They also put the wellhouse on a foundation, built a safety retaining wall behind the house, and handled the remaining electrical, water, and sewer trenching.

Hand it to a property manager

After the Certificate of Occupancy in July 2025, I signed with Vacasa to run it as a short-term rental. It went live on October 10, 2025. In March 2026, Vacasa assigned my contract to another management company.

The First Year After the Certificate of Occupancy

July 31, 2025 through October 2026.

The hydrogen sulfide saga: about 9,100 USD so far

The well water smells like rotten eggs. That is hydrogen sulfide (H2S) gas, and it showed up in spring 2025, right as the house was getting ready for guests. Sulfate-reducing bacteria feed on the sulfate in the water and give off H2S. My 2024 well test showed high sulfate, a pH of 8.05, and almost no iron (0.083 mg/L).

  • Spring 2025: the water treatment system (UV and under-sink reverse osmosis), 15,096 USD. Installed with the pump and pressure tank. The kitchen tap was great. Every other tap still smelled.
  • August-September 2025: carbon block filters in the pumphouse, 1,296 USD. Worked for 5-6 months.
  • February-March 2026: the smell came back. Replaced every filter, including the UV and reverse osmosis, for 2,214 USD. The odor in the house was gone, but the gas at the well was the same. The driller floated a cistern to aerate the water if it got worse.
  • September 2026: back in force. The property manager smelled it dropping off supplies. I put a maintenance hold on the calendar from September 9 to October 28 instead of collecting bad reviews.
  • October 21, 2026: an air injection sulfur filter with an ozone kit, 5,618 USD. Air injection oxidizes the H2S before it reaches the pressure tank, so there is no carbon media to foul every 3-6 months.

What I would do differently: get an on-site H2S reading before buying anything. Nobody ever measured the sulfide level, so every fix was a guess.

Everything else

  • Leach field repair, April 2026: 1,480 USD. A fitting in the original septic install was the wrong type.
  • Mini-split, May-June 2026: no heat or cooling in any zone. I reached out to half a dozen HVAC companies before one fixed a leaking line set.
  • Electrical breakers, September 2026: breaker problems. The fix is bundled with the EV charger install.
  • Deck, September 2026: about 4,000 USD in labor. An 8x8 dining area and a 4x14 walkway out front, in composite, for shoulder season appeal.
  • Level 2 EV charger, September-October 2026: 1,170 USD in hardware. Install in progress.
  • Running costs: property insurance through the Colorado FAIR Plan at 1,632 USD a year, a 724 USD county vacation rental permit, a radon test (2.6 pCi/L, no mitigation needed), and snow removal.

Did It Work?

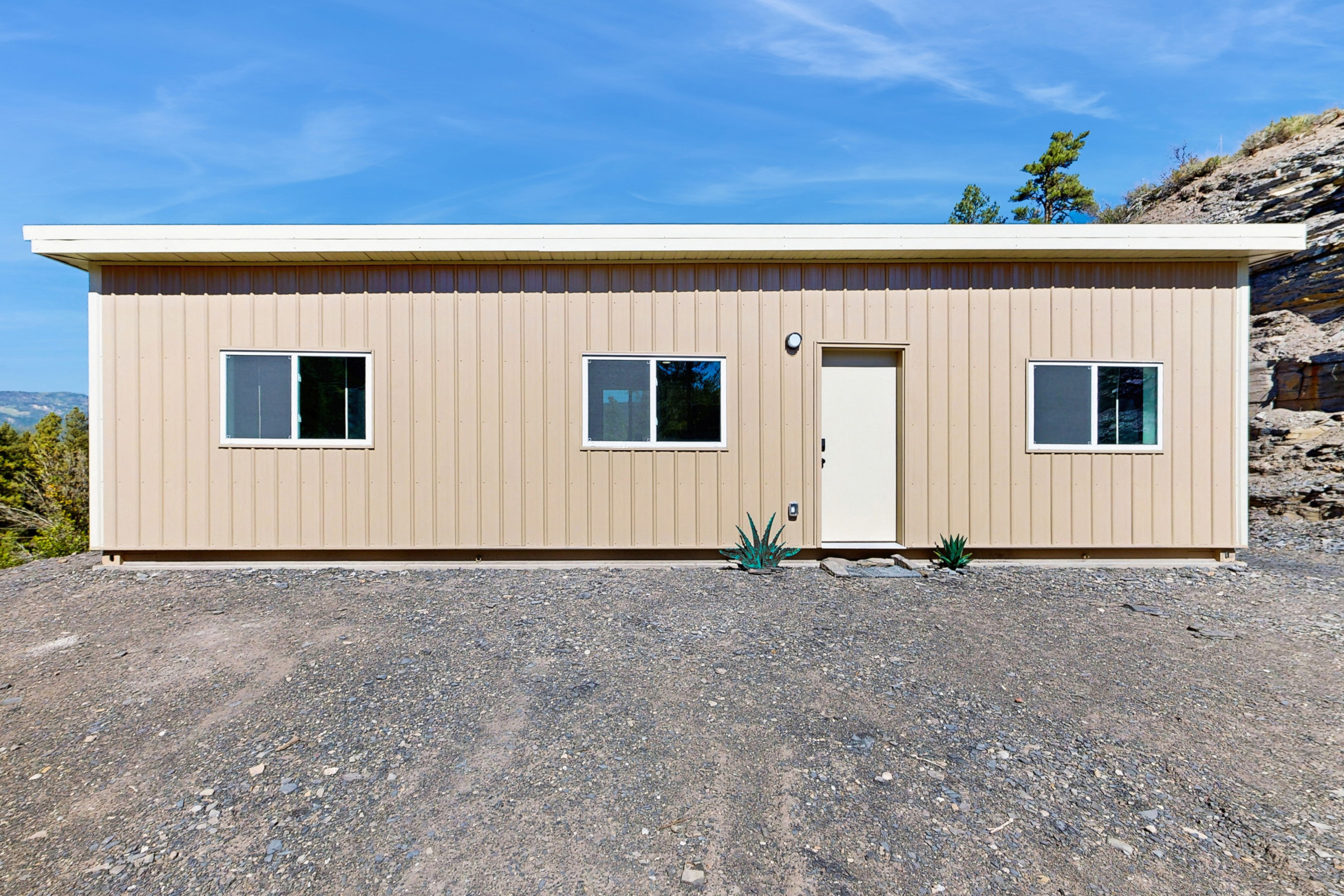

The house: yes. The finished container home in August 2025 Fire resistant metal roof and siding, defensible space with all the shale exposed, and a south-facing driveway to keep the snow off. A Type II: Noncombustible structure in this area made the property insurance premium a lot easier.

Southwest decor inside the container home I am very happy with the Southwest decor we found at Camino Real Imports! I always fantasized about a cozy home in the desert Southwest and stumbled into it with the right siting and accents.

The money: not yet. It took over four years from land to Certificate of Occupancy. Here is what it cost, matching my October 2026 cost reconciliation for taxes:

What Cost
Land (12,500 USD price plus closing) 13,650 USD
Site work: excavation, septic, driveway, retaining wall, utility connection 203,205 USD
Well, pump, and water treatment 125,476 USD
Building and foundation: the house, foundation, electrical 272,261 USD
Soft costs: engineering, geotech study, general contractor fee 16,408 USD
Construction total 617,350 USD
All-in with land 631,000 USD

Furnishings are not in there yet. Add a professional manager taking their cut. Then the first year added about 9,100 USD chasing the smell, a few thousand in repairs, and seven weeks blocked off on the calendar. The cash flow came in under the number JZ the business needs.

What I would tell you before you try this:

  • Flat lots are cheaper. The hillside roughly doubled excavation and added 25-50% to the well.
  • Water is the gamble. About 125,000 USD, and the well comes with no guarantee of water.
  • Hire a general contractor for the foundation. Remote, with no GC experience, I could not have done it.
  • Concrete crews are the bottleneck. I lost the whole 2024 building season trying to find reliable concrete workers.
  • Chase the paperwork. The final state stamp sat for months waiting on paperwork from the house manufacturer.
  • Test the water for what you are actually fighting. Measure H2S on site before picking a treatment.

What Is Next: AI-Led Management

The same bet I made with Vraid Systems: the clerical work is what eats the margin, and LLMs are good at clerical work. Guest messaging, pricing, and scheduling are mostly clerical work, and that is a big part of what a property manager charges for. In October 2026 I gave my property manager notice and started running it myself, with AI doing most of the work.

Running it myself also builds toward the hours the IRS wants to see for a rental to count as a real business. More on that in the Colorado LLC post.

Book a stay: https://pagosacontainerhome.com/

Chronology

  • March 31, 2021: The “Contract to Buy and Sell Real Estate” for the raw land was executed.
  • April 22, 2021: Closing and transfer of possession.
  • January 5-6, 2022: Submitted the initial “On-site Wastewater Treatment System” (OWTS) permit application and paid the $1,023 fee.
  • February 14, 2022: First contact with Luke McCauley (Pagosa Landworks) about excavation and site prep.
  • April 6, 2022: Paid a deposit to Davis Engineering for a “Proposed Site Plan” (PSP), topographic survey, and septic system design.
  • April 25, 2022: Davis Engineering’s topographic survey found steep slopes (30-40% grade) that required additional geological review.
  • July 5, 2022: Started detailed discussions with Robert Wagoner at Custom Container Living about the “Double Duo” 2-bedroom modular home.
  • September 21, 2022: Trautner Geotech sent a proposal for the required geotechnical engineering and slope stability study.
  • December 9, 2022: The final “Limited Geotechnical Engineering Study” was issued: go-ahead for construction, with specific foundation requirements.
  • December 22, 2022: La Plata Electric Association (LPEA) issued the construction invoice for new electric service (Work Order #20221126).
  • May 25, 2023: Davis Engineering finished the preliminary driveway and building pad design.
  • November 9, 2023: Final driveway and building pad design done.
  • February 14, 2024: LPEA crews installed the meter pedestal on pole 8985.
  • February 28, 2024: Archuleta County Water Quality Department authorized OWTS (septic) construction.
  • March 25, 2024: Switched the water source from a cistern to a drilled well.
  • July 15, 2024: Construction loan agreement finalized with REDACTED.
  • Summer-Fall 2024: Lost the rest of the building season because I could not find reliable concrete workers locally.
  • February 18, 2025: Signed a statement of work with Hiver Salley (HYS Construction) for the final foundation (slab, piers, and footers) and site prep.
  • April 1, 2025: Signed a second Electric Facilities Agreement with LPEA for another 200A meter socket (Work Order #20250633). They had given the first one to a different customer.
  • April 15, 2025: Final coordination and payments to DAK Drilling for the well pump and water filtration system.
  • April 23, 2025: Custom Container Living delivered the structure.
  • May-July, 2025: Right of way final inspection required updates to the driveway culvert. The final state of Colorado stamp was held up by missing paperwork from Custom Container Living.
  • July 31, 2025: Certificate of Occupancy from Archuleta County.
  • August 8, 2025: Signed a “Vacation Rental Services Agreement” with Vacasa to manage the property.
  • August-September, 2025: Several trips to decorate, furnish, and prep the house to Vacasa’s specs.
  • August 21, 2025: Archuleta County vacation rental permit, 724 USD.
  • September 2, 2025: DAK Drilling installed carbon block filters in the pumphouse for the H2S smell.
  • September 26, 2025: Septic pump panel rewired, 480 USD.
  • October 10, 2025: Listed and live as a short-term rental.
  • October 24, 2025: Property insurance through the Colorado FAIR Plan, 1,632 USD.
  • February 2, 2026: Radon test, 2.6 pCi/L, no mitigation needed.
  • February 16, 2026: H2S smell back after 5-6 months.
  • March 5, 2026: DAK replaced all filters (carbon, UV, reverse osmosis), 2,214 USD.
  • March 23, 2026: Vacasa assigned the management contract to another company.
  • April 21, 2026: Leach field repaired, 1,480 USD.
  • May-June, 2026: Mini-split stopped heating and cooling. Line set leak repaired in late June.
  • August 2026: Vacation rental permit renewed.
  • September 1, 2026: Electrical breaker issues. Started planning a Level 2 EV charger and a front deck.
  • September 4, 2026: H2S smell back in force.
  • September 9, 2026: Maintenance hold on bookings through October 28.
  • September 15-21, 2026: Deck built, about 4,000 USD in labor. EV charger hardware bought, 1,170 USD.
  • October 13, 2026: Gave the property manager notice.
  • October 14-19, 2026: Ordered an engineered cost segregation study.
  • October 21, 2026: DAK installed an air injection sulfur filter with an ozone kit, 5,618 USD. Management by the property manager ended the same day, and I moved to AI-led self-management.
///
